Micron says New York chipmaking fabs still on track according to its latest timelines — accelerates second fab in Idaho and reallocates CHIPS Act funding (Updated)

Micron's offices in Allen, Texas
(Image credit: Credit: Micron Technology)
Recent updates

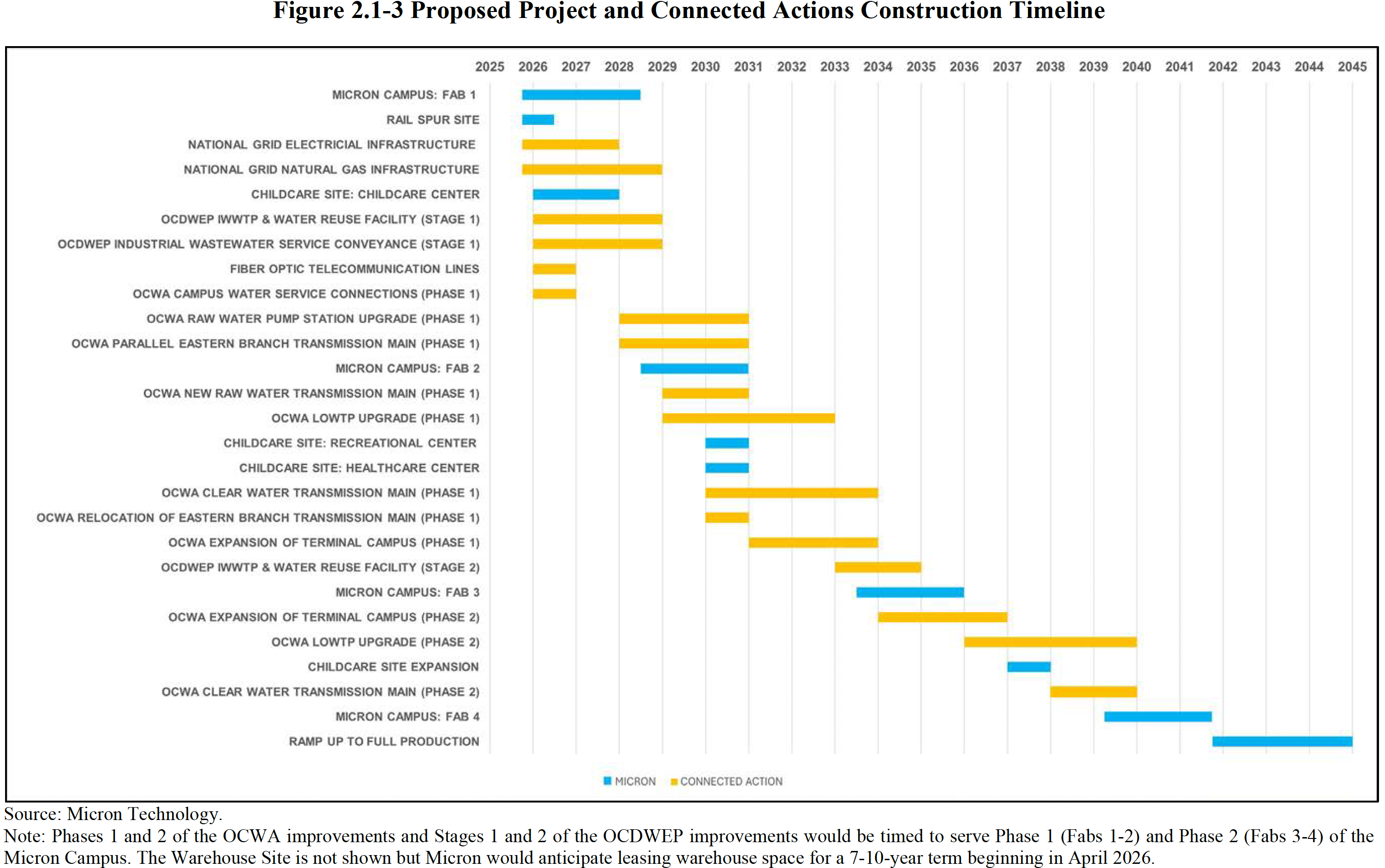

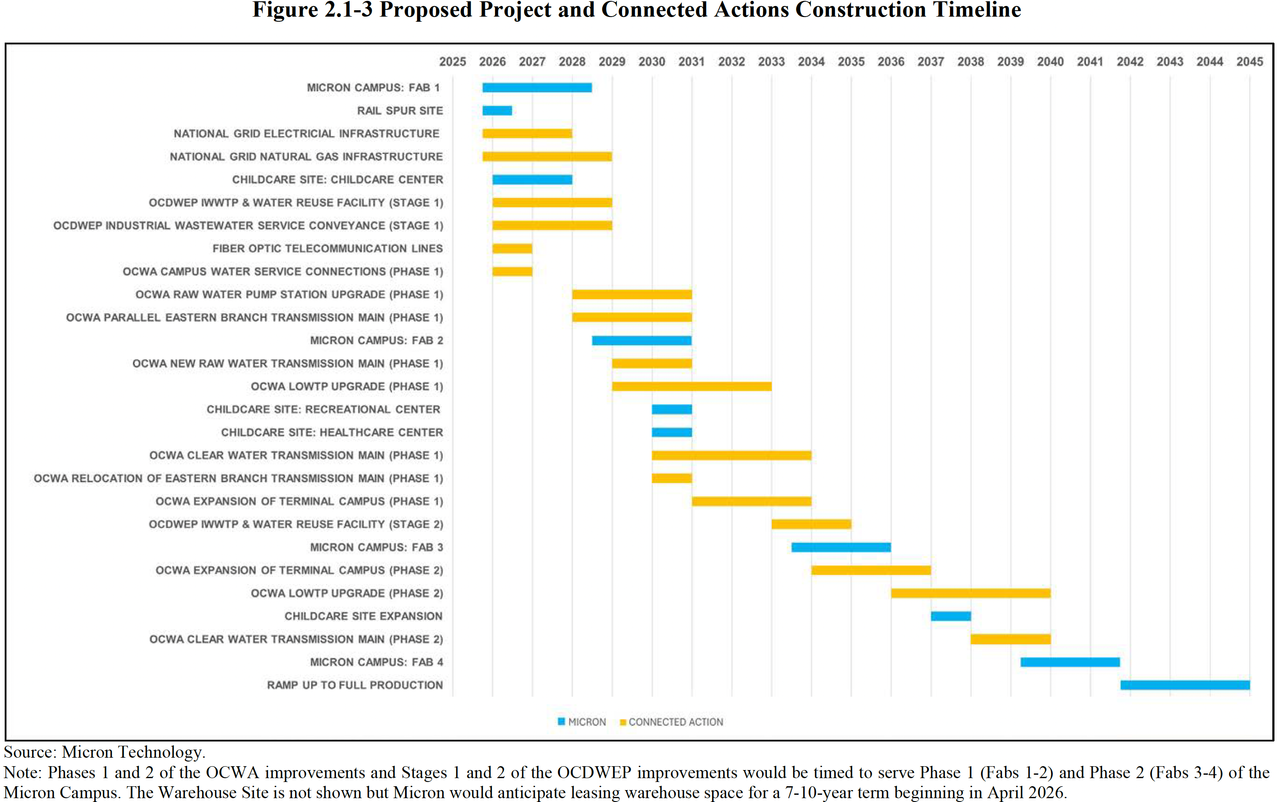

UPDATE 11/11/2025: Micron has provided Tom's Hardware with the latest version of its Environmental Impact Statement (EIS) that details the plans for the company's fab complex in New York. As it appears, there are no delays compared to the timelines that Micron announced in mid-2025. As expected, construction of the first fab will start in late 2026, will be completed in 2028, and the fab will come online in circa 2030. We have updated this story in accordance with the latest version of the EIS

Latest Videos FromTom's Hardware
TOPICS
Anton Shilov
Contributing Writer

Anton Shilov is a contributing writer at Tom’s Hardware. Over the past couple of decades, he has covered everything from CPUs and GPUs to supercomputers and from modern process technologies and latest fab tools to high-tech industry trends.
